⬅️PROCEDURES

CP6: SHEQ

This procedure describes how Breheny Civil Engineering Ltd manages Safety, Health, Environment and Quality (SHEQ) across a project: inductions, risk assessment, permits, high-risk activities, emergency planning, inspections, communication, training, environmental controls and quality checks.

35
Sections
174
Key points

In this procedure

  1. 1Purpose and Scope1 part

    1 Purpose and Scope

    This section of CP6: SHEQ  explains what the document is for and what it covers. Essentially, it sets out the reasons why we have this procedure and the boundaries of its application. It's important for all site staff to understand this so we know which aspects of our work are guided by CP6: SHEQ  regarding Safety, Health, Environment, and Quality (SHEQ).

    It outlines the principles and responsibilities we all share to ensure our operations meet the required SHEQ standards, contributing to a safe workplace and environmental protection.

    Key points

    • This section outlines the 'why' and 'what' of the CP6: SHEQ  procedure, defining its purpose and scope.
    • It establishes the foundational principles for Safety, Health, Environment, and Quality (SHEQ) within our operations.
    • Understanding this section is critical for all site staff to know their SHEQ responsibilities related to CP6: SHEQ .
    • The document guides our operations to meet SHEQ standards, ensuring a safe workplace and environmental protection.
    From the source document(3 clauses)

    1Purpose and Scope

    No text in source for this clause.

    1.1.1EditedAdded

    This procedure sets out the standard processes for implementing an effective Integrated Management System (IMS). It covers key elements of Safety, Health, Environmental, and Quality (SHEQ) management, including communication, consultation, risk assessment, inspections, audits and reviews, and corrective actions

    1.1.2EditedAdded

    The IMS is designed to ensure that all projects are delivered safely, in compliance with legal and environmental requirements, and to the quality standards expected by our Clients. Through this integrated approach, we aim to prevent harm to people and the environment while driving continuous improvement across all areas of our operations.

  2. 2Site Inductions1 part

    2 Site Inductions

    Before you start work on site, you need to have a current skill card that matches your job (like CSCS, CPCS, or NPORS). You must give us your skill card details before your site induction.

    At the induction, you need to show us your physical card(s). We'll make a copy for our records, which will be kept with your induction form ( Site Induction Record). Your card might also be checked with the issuer at any time. We also accept competency cards from CSCS partner schemes (you can find more info at: https://www.cscs.uk.com/about/cscs-alliance/). Our client must also accept your card.

    Key points

    • All site personnel must hold a current and relevant skill card (e.g., CSCS, CPCS, NPORS) for their duties.
    • Skill card details must be provided before attending site induction.
    • Physical skill card(s) must be presented at induction before commencing work on site.
    • A copy of the skill card will be retained with the induction record form.
    • Cards are subject to random verification with the card issuer and must be accepted by the client.
    • Competency cards from recognised CSCS partner schemes are also accepted.
    From the source document(9 clauses)

    2Site Inductions

    No text in source for this clause.

    2.1.1EditedAdded

    The Delivery Team shall ensure that all personnel who are to work on a project, receive a site induction before they commence any work on site.

    2.1.2EditedAdded

    All personnel working on the project shall be required to hold a current skill card (e.g. CSCS / CPCS / NPORS) for the duties they are undertaking. All personnel shall provide details of their skill card(s) prior to attending the site induction and present the actual card(s) at induction before commencing work on site. A copy of the card shall be made and retained with the induction record form. Cards shall be presented on request and will be subject to random verification with the card issuer. BCE also accept competency cards from a recognised CSCS partner scheme, details of which can be found on the following hyperlink; https://www.cscs.uk.com/about/cscs-alliance/ The card shall also be accepted by our Client.

    2.1.3EditedAdded

    Individuals who have not yet acquired the necessary skills to obtain a skill card shall have passed the CITB Health, Safety and Environment Test and be able to demonstrate the process for obtaining their card during induction. For example, this may include having passed or being registered for the Site Safety Plus Health and Safety Awareness Course, enrolling in the relevant NVQ, or working towards a card through the Academic or Professional route. The period between passing the CITB Health, Safety and Environment Test and beginning the process to obtain the card shall not exceed three months.

    2.1.4EditedAdded

    BCE Site Inductions are to be given for all sites irrespective of whether or not BCE’s Client may also give a site induction.

    2.1.5EditedAdded

    All employees, contractors and LOSCs, who attend site regularly are required to watch the Company’s “Health Safety and Environment” Induction film; a test of knowledge and understanding shall be taken and passed using the approved question form before commencing work on site; the BCE site induction is valid for a year.

    2.1.6EditedAdded

    The latest version of the induction film is available on the EDMS and online. In addition to English, it is also available in Punjabi, Romanian and Polish.

    2.1.7EditedAdded

    The Company maintains an Unsafe Persons database within the EDMS, listing individuals who are prohibited from working on BCE projects due to safety violations or failed drugs and alcohol tests. The database is structured in accordance with current legislation and internal procedures. During a site induction, the inductee’s CSCS, CPCS, or NPORS card number can be checked against the database to alert the Delivery Team of any breaches of BCE procedures. For further guidance, refer to Standards & Guidance 052 – Disciplinary Process.

    2.1.8EditedAdded

    The Delivery Team shall record the induction training given on the Site Induction Record (Form CP6-F13).

    Documents you'll need

  3. 3Hazard Identification and Risk Assessment1 part

    3 Hazard Identification and Risk Assessment

    Managing health, safety, and environmental risks (SHEQ) is crucial throughout our projects. The Delivery Team identifies and assesses risks from the start, continuously monitoring them in line with ISO 45001 principles. Our overall approach follows Hazard Identification & Risk Assessment.

    This involves reviewing project details, identifying hazards (including environmental risks), and considering everyone at risk, especially vulnerable groups. We assess how severe and likely risks are, evaluate existing controls, and implement new measures if needed. All Risk Assessments are recorded and communicated to staff and operatives, including through project-specific RAMS created using Risk Assessment Form and Method Statement Form . Every RAMS is logged on the RAMS Register (), evaluated for subcontractor packages via the SC RAMS Evaluation (), and reviewed by the Contracts Manager / Senior Project Manager using RAMS Review. On the day, operatives confirm conditions still match the plan through a Point of Work Risk Assessment ().

    Activity-specific assessments are completed where the hazard applies:

    • VibrationVibration Risk Assessment () in line with HAVS; where exposure exceeds the EAV, operatives (including subcontractors) complete a BCE Individual Weekly Vibration Log (), signed by both the operative and supervisor. Those diagnosed with HAVS must log all vibratory tool usage.
    • NoiseNoise Assessment Record () following Workplace Noise.
    • Manual handlingManual Handling Assessment ().
    • Hazardous substancesCOSHH Assessment Suite () following Hazardous Substances.
    • FireFire Risk Assessment and Fire Plan ().

    RAMS and all supporting assessments are reviewed after incidents, significant changes, or updates to laws to ensure controls remain effective.

    Key points

    • The Delivery Team is responsible for managing project health, safety, and environmental risks, continuously monitoring them following ISO 45001 principles.
    • Risk assessments involve reviewing project information, identifying hazards (including environmental risks) and individuals at risk, assessing severity and likelihood, and evaluating existing controls.
    • Project-specific RAMS are prepared using Risk Assessment Form and Method Statement Form .
    • RAMS and noise risk assessments are reviewed after incidents, significant changes, or legislative updates.
    • Operatives using vibrating tools must complete a BCE Individual Weekly Vibration Log (Form ) if exposure is above the EAV, ensuring it's signed by both operative and supervisor.
    From the source document(25 clauses)

    3Hazard Identification and Risk Assessment

    No text in source for this clause.

    3.1.1The Delivery Team is responsible for managing health, safety, and environmental risks throughout the project lifecycle. Risks shall be identified and assessed at project initiation and continuously monitored, following ISO 45001 principles.Edited

    The Delivery Team is responsible for managing health, safety, and environmental risks throughout the project lifecycle. Risks shall be identified and assessed at project initiation and continuously monitored, following ISO 45001 principles.

    The process includes:

    • Reviewing project information, legislation, and regulations.
    • Considering current and potential future tasks, activities, and site conditions.
    • Identifying hazards, including environmental risks (e.g. pollution, waste, impact on habitats), and improvement opportunities.
    • Identifying all individuals at risk, including the public, with attention to vulnerable groups.
    • Assessing the severity, likelihood, and potential consequences of exposure.
    • Evaluating existing controls and determining if they adequately mitigate risks; if not, residual risks shall be addressed with appropriate measures.
    • Implement control measures.
    • Recording Risk Assessments and ensuring communication and understanding by all staff and operatives.
    • Monitoring control measures for effectiveness.
    • Reviewing and updating processes regularly, introducing corrective actions as needed for continuous improvement.

    For further guidance, see S&G 032 Hazard Identification and Risk Assessment (HIRA).

    3.2Risk Assessments and Method Statements (RAMS)EditedAdded

    3.2.1 Template task-specific RAMS are available on the EDMS and can be adapted to create project-specific RAMS. Contact the SHEQ Department if new assessments are required. Project-specific RAMS shall be prepared using: • Risk Assessment Form CP6-F01 • Method Statement Form CP6-F02

    3.2.2EditedAdded

    RAMS shall cover safety, health, environmental and quality risks for all significant tasks. Each assessment shall have a unique reference number. Forms may be modified to meet Client requirements.

    3.2.3EditedAdded

    For maintenance, emergency, or short duration works, the Point of Work Risk Assessment (Form CP6-F03) may be used.

    3.2.4EditedAdded

    All RAMS shall be prepared by a competent person, approved and signed by the Contracts Manager or nominated representative before briefing.

    3.2.5EditedAdded

    Delivery Teams shall brief RAMS to the relevant staff. Signatures shall be recorded on the Signatories’ Record Sheet (Form CP6-F02).

    3.2.6EditedAdded

    A Risk Assessment and Method Statement Register (Form CP6-04) shall be used to record all RAMS generated for the project.

    3.3Subcontractor RAMSEditedAdded

    3.3.1 Subcontractor RAMS shall be reviewed using (Form CP6-F05) and accepted by the Delivery Team before submission to the Client and prior to starting work. Non-compliant documents shall be rejected and must be corrected before work commencement. RAMS shall include clear work descriptions, plant/equipment, supervision, control measures, and PPE requirements.

    3.3.2EditedAdded

    RAMS shall be submitted two weeks prior to the commencement of works, and no later than 24 hours in advance, to allow review, briefing, training, and resource allocation.

    3.4RAMS ReviewEditedAdded

    3.4.1 Where RAMS are in use for longer than six months, the Delivery Team shall review and revise as necessary and record on the relevant section of (Form CP6-F02). The Contracts Manager shall undertake a six-monthly RAMS review to ensure high risk activities are properly identified and controlled and record the review on the RAMS Review Form (Form CP6-F06).

    3.4.2EditedAdded

    RAMS reviews shall also be conducted:

    After any incidents or significant near misses

    Following significant changes in work processes, plant / equipment, or substances used

    When legislation or regulations change

    When project complexity or risk level changes

    3.5COSHH AssessmentEditedAdded

    3.5.1 The Delivery Team shall ensure that all hazardous substances used on the project have a current Material Safety Data Sheet (MSDS) and COSHH assessment. If a substance poses significant risk, alternative safer substances must be considered. A suite of COSHH assessments (Form CP6-F12) have been produced and are available on the EDMS, which can be developed to make them project-specific and are supported with the relevant MSDS. If new COSHH assessments are required, the SHEQ Department shall be contacted.

    3.5.2EditedAdded

    COSHH assessments shall be integrated into the task specific RAMS package and briefed to those involved in the task and anyone who may be affected. The Signatories’ Record Sheet (Form CP6-F02) shall be signed.

    3.5.3EditedAdded

    The Contracts Manager is responsible for ensuring that the production of COSHH assessments is undertaken by the Delivery Team.

    3.6Manual Handling Risk Assessments.EditedAdded

    3.6.1 The Delivery Team shall carry out specific Manual Handling Risk Assessments using (Form CP6-F11) for all operations involving lifting, pushing, or pulling items weighing more than 20 kg, prior to the operation commencing.

    3.6.2EditedAdded

    A suite of task-specific manual handling assessment templates has been produced and is available on the EDMS. These templates can be adapted for individuals or groups of workers.

    3.6.3EditedAdded

    Manual Handling Assessments shall be integrated into the task specific RAMS package and briefed to those involved in the task and anyone who may be affected. The Signatories’ Record Sheet (Form CP6-F02) shall be signed.

    3.6.4EditedAdded

    Manual handling training shall be provided to the Operation Team engaged in repetitive manual handling activities.

    3.7Noise Risk AssessmentsEditedAdded

    3.7.1 The Delivery Team is responsible for ensuring that noise risk assessments are carried out on all construction projects where noise levels may exceed safe exposure limits, using (Form CP6-F10).

    3.7.2EditedAdded

    Noise risk assessments shall be carried out:

    At the start of the project, before noisy activities begin.

    When new equipment or processes are introduced that may increase noise levels.

    When significant changes to work methods or site conditions occur.

    3.7.3EditedAdded

    Noise Assessments shall be integrated into the task-specific RAMS package and briefed to those involved in the task and anyone who may be affected. The Signatories’ Record Sheet (Form CP6-F02) shall be signed.

    3.8Vibration Risk AssessmentsEditedAdded

    3.8.1 The Delivery Team shall ensure that vibration risk assessments and monitoring is undertaken on each site in accordance with company standards and guidance. A vibration risk assessment (CP6-F08) shall be carried out where an operative will be exposed to vibration. The Delivery Team is to ensure that no operative exceeds the Daily Exposure Limit Value (ELV) or Daily Exposure Action Value (EAV) in the case of an employee with a formal HAVS diagnosis.

    3.8.2EditedAdded

    The Operatives, including subcontractors, shall complete a BCE Individual Weekly Vibration Log (Form CP6-F09) to record vibration exposure where the Risk Assessment indicates exposure above the EAV. The Delivery Team shall ensure that:

    All vibration logs are fully completed.

    Both the operative and supervisor have signed the log.

    Operatives formally diagnosed with HAVS log all vibratory tool usage.

    3.8.3EditedAdded

    S&G 005 HAVS provides further guidance on vibration management.

    Documents you'll need

  4. 4Permits to Work1 part

    4 Permits to Work

    For many tasks performed on-site, a Permit to Work is required to ensure safety and proper procedures are followed. These permits document activities, potential hazards, and necessary controls.

    You'll typically need a permit for tasks like:

    • Breaking Ground: Use Form for Services Location and Form for Main Works.
    • General Tasks: Form is used for general work activities.
    • Specialized Activities: This includes entering Confined Spaces (Form ), performing Hot Work (Form ), Electrical Work (Form ), working near Overhead Services (Form ), and Work at Height (Form ).
    • Proceeding with Work: Ensure you have a Form , Permit to Proceed, when necessary.

    Every issued permit must be logged on the Permit Register so the site has a live record of what's authorised, by whom, and when it expires.

    Always confirm which permit is required for your specific job before starting work.

    Key points

    • A Permit to Work is required for high-risk activities before work begins.
    • Break-ground work: (Services Location) then (Main Works).
    • General tasks: . Confined Spaces: . Hot Work: . Electrical: . Overhead Services: . Work at Height: .
    • Temporary Works handovers use Permit to Proceed.
    • Every issued permit must be logged on Permit Register.
    • Confirm which permit is required before starting work.
    From the source document(5 clauses)

    4Permits to WorkEdited

    4.1.1 The Delivery Team shall implement a Permit to Work (PTW) system for all high-risk operations on site. Permits are issued by the Delivery Team to the person responsible for overseeing the task and shall comply with Company Standards & Guidance.

    4.1.2Permits will typically be required for the following tasks:Edited

    Permits will typically be required for the following tasks:

    • Form CP6-F33 Permit to Break Ground - Part A (Services Location).
      • Form CP6-F34 Permit to Break Ground - Part B (Main Works).
      • Form CP6-F35 General Permit to Work.
      • Form CP6-F36 Confined Space Permit to Work.
      • Form CP6-F37 Hot Work Permit.
      • Form CP6-F38 Electrical Permit to Work.
      • Form CP6-F39 Overhead Services Permit.
      • Form CP6-F41 Permit to Work at Height.
      • Form CP6-F54 Permit to Proceed

    4.1.3EditedAdded

    Permits shall be recorded on the Permit Register form CP6-F42

    4.1.4EditedAdded

    For non-English speaking workers performing high-risk activities, including those requiring a Permit to Work, the BCE Non-English-Speaking Workers Policy shall be consulted prior to planning the work.

    4.1.5EditedAdded

    S&G 004 Permits to Work provides further guidance on the use of PTW.

    Documents you'll need

  5. 5High Risk Activities7 parts

    5.1 Lifting Operations

    Every lifting operation must be risk assessed, properly planned, and executed with suitable equipment by trained, competent people (clause 5.1.1).

    The Contracts Manager formally assigns the Appointed Person (AP) and Lift Supervisor using (or where applicable) — clauses 5.1.2–5.1.3.

    The AP prepares the lift plan / safe system of work on Lift Plan, ensuring all lifting activities follow the approved plan and relevant safety standards (clause 5.1.4). The AP also assesses ground bearing capacity using the Company's Excavator Track Pressure Assessment Tool and includes the output in the lift plan (clause 5.1.5).

    A Lift Supervisor must be assigned to all lifting operations and present on site — or directly overseeing the lift, depending on complexity (clause 5.1.6). Before the lift, the Lift Supervisor briefs all personnel involved and captures their signatures on the lift plan () — clauses 5.1.7–5.1.8.

    Key points

    • Clause 5.1.1 — all lifting operations must be risk assessed, planned and carried out by trained, competent people.
    • Clauses 5.1.2–5.1.3 — Contracts Manager assigns the AP and Lift Supervisor using Form (or where applicable).
    • Clause 5.1.4 — AP prepares the lift plan / safe system of work on Form .
    • Clause 5.1.5 — AP assesses ground bearing capacity using the Company's Excavator Track Pressure Assessment Tool and records it in the lift plan.
    • Clause 5.1.6 — Contracts Manager ensures a Lift Supervisor is assigned and present for all lifts.
    • Clauses 5.1.7–5.1.8 — Lift Supervisor briefs all personnel and captures signatures on before the lift proceeds.
    From the source document(9 clauses)

    5.1Lifting OperationsEditedAdded

    No text in source for this clause.

    5.1.1EditedAdded

    The Delivery Team is responsible for ensuring that all lifting operations are risk assessed, properly planned, and executed using suitable lifting equipment by trained and competent personnel.

    5.1.2EditedAdded

    The roles of the Appointed Person (AP) and Lift Supervisor shall be formally assigned by the Contracts Manager (Form CP6-F61 or F62).

    5.1.3EditedAdded

    The roles of the Appointed Person (AP) and Lift Supervisor shall be formally assigned by the Contracts Manager (Form CP6-F61 or F62).

    5.1.4EditedAdded

    The AP shall prepare a lift plan/safe system of work using (Form CP6-F07), ensuring all lifting activities follow the approved lift plan and relevant safety standards.

    5.1.5EditedAdded

    The AP shall assess ground bearing capacity using the Company’s Excavator Track Pressure Assessment Tool and include the output in the lift plan.

    5.1.6EditedAdded

    The Contracts Manager shall ensure that a Lift Supervisor is assigned to all lifting operations. The Lift Supervisor shall be present on site or directly oversee the lift, depending on the complexity of the operation.

    5.1.7EditedAdded

    The Lift Supervisor shall brief all personnel involved in the lift and capture their signatures on the lift plan (Form CP6-F07).

    5.1.8EditedAdded

    The Lift Supervisor shall brief all personnel involved in the lift and capture their signatures on the lift plan (Form CP6-F07).

    Documents you'll need

    5.2 Temporary Works

    Temporary Works must be identified, designed, executed and managed in line with Temporary Works and BS 5975-1 (clause 5.2.1).

    Step 1 — Classification. All Temporary Works are classified and recorded on Classification of Temporary Works (now incorporated within the ROMP). This is completed at Pre-Contracts stage by the Estimator with Pre-Contracts Team support (clause 5.2.2).

    Step 2 — Appointments (clause 5.2.3). The chain of responsibility is set up in writing:

    • Designated Individual (DI) — the Contracts Director is appointed on Appointment of Designated Individual.
    • Nominated Representative — the DI appoints the Contracts Manager on Letter of Appointment of DI's Nominated Representative.
    • Temporary Works Co-ordinator (TWC) — appointed by the nominated representative on Appointment of TWC.
    • Temporary Works Supervisor (TWS) — may be appointed by the TWC on Appointment of Site TWS.

    Step 3 — Competency (clause 5.2.4). The DI or TWC must verify that anyone appointed to a temporary works role has the necessary skills, knowledge and experience before they start. Where no existing framework exists, use the Company's assessment checklists: (Designer), (TWD), (TWDC), (PC's TWC) and (TWS).

    Step 4 — Register (clause 5.2.5). The TWC creates and maintains the Temporary Works Register and is responsible for ensuring all inspections, permits and checks are completed and recorded, assisted by the TWS.

    Step 5 — Operational forms (clause 5.2.6). The TWC/TWS uses:

    • Design Brief Form — as required
    • Permit to Proceed — as required
    • Temporary Works Inspection Form — frequency set by TWC
    • Temporary Works Safety Checklist — frequency set by TWC (Part B variants /B/C/D/E for earthworks, formwork/falsework, groundwork, piling and scaffold/fences)

    Key points

    • Clause 5.2.1 — Temporary Works must comply with and BS 5975-1.
    • Clause 5.2.2 — Classify all Temporary Works on Form (within the ROMP) at Pre-Contracts stage.
    • Clause 5.2.3 — Contracts Director appointed as DI on ; DI appoints Contracts Manager as Nominated Representative on .
    • Clause 5.2.3 — TWC appointed on ; TWS appointed on .
    • Clause 5.2.4 — Competency verified before appointment using (Designer), (TWD), (TWDC), (PC's TWC) or (TWS).
    • Clause 5.2.5 — TWC maintains the Temporary Works Register on .
    • Clause 5.2.6 — Use Design Brief, Permit to Proceed, Inspection, Safety Checklist (Part B variants /B/C/D/E).
    From the source document(7 clauses)

    5.2Temporary WorksEditedAdded

    5.2.1EditedAdded

    The Delivery Team shall ensure all Temporary Works are identified, executed, and managed in line with S&G 046 & BS 5975-1.

    5.2.2EditedAdded

    All Temporary Works shall be classified and recorded using (Form CP6-F52) which is included in the ROMP. This is completed during the Pre-Contracts stage by the Estimator with Pre-Contracts Team support.

    5.2.3EditedAdded

    The Contracts Director is to be appointed as the Designated Individual (DI) for the Company using (Form CP6-F73), the Designated Individual, shall appoint the Contracts Manager as a nominated representative using (Form CP6-F57). The nominated representative is responsible for appointing a Temporary Works Coordinator (TWC) using (Form CP6-F55), who may then appoint a Temporary Works Supervisor (TWS) using (Form CP6-F56).

    5.2.4EditedAdded

    The DI or TWC must ensure that anyone appointed to a temporary works role has the necessary skills, knowledge, and experience, with competence verified before they start. This can be done by directly assessing each individual or confirming the relevant Designer uses a robust, documented competency assessment process. In the absence of an existing competency assessment framework, the DI or TWC shall utilise the Company’s competency assessment checklists for the relevant temporary works roles: Form CP6-F68 - Designer Competency Assessment. Form CP6-F69 - BCE Temporary Works Designer (TWD) Competency Assessment. Form CP6-F70 - Temporary Works Design Checker (TWDC) Competency Assessment. Form CP6-F71 - PC’s TWC/TWC Assessment. Form CP6-F72 - TWS Competency Assessment.

    5.2.5EditedAdded

    A Temporary Works Register shall be created and maintained by the TWC, using (Form CP6-F58). The TWC is responsible for ensuring all inspections, permits, and checks related to temporary works are completed and recorded. The TWS shall assist with management and inspection.

    5.2.6EditedAdded

    The following forms shall be used in the management of Temporary Works: Form CP6-F53 - Design Brief Form – TWC to complete as required. Form CP6-F54 - Permit to Proceed – TWC to complete as required. Form CP6-F59 - Temporary Works Inspection Form – TWC / TWS to complete as required. Frequency determined by TWC. Form CP6-F60 - Temporary Works Safety Checklist – TWC / TWS to complete as required. Frequency determined by TWC.

    Documents you'll need

    5.3 Excavations

    Before any digging can start, you must have a Permit to Break Ground. This applies to all excavation work. Use Permit to Break Ground - Part A (Services Location) to locate and confirm buried services, then Permit to Break Ground - Part B (Main Works) to authorise the main dig.

    This permit ensures we follow important safety guidelines, especially those outlined in:

    • - Buried Services: General rules for working near buried utilities.
    • - Buried Services - excavating within the 500mm safety zone: Specific instructions when digging close to underground services (within 500mm).
    • - Excavations: General excavation procedures and safety measures.

    Where vacuum excavation is used to support the dig, the operator and supporting personnel must be authorised via Vac-Ex Supporting Personnel Authorisation.

    Once the excavation is open, it must be inspected and recorded using Excavation Inspection at the required intervals (start of shift, after any event likely to affect stability, and at least weekly). The supporting Risk Assessment and Method Statement must be in place and briefed before work begins, with a Point of Work Risk Assessment completed by the gang on the day.

    Always secure your permits first to keep everyone safe and avoid damaging crucial underground infrastructure.

    Key points

    • A Permit to Break Ground (PTBG) is mandatory for all excavation activities.
    • The PTBG ensures compliance with ' - Buried Services' and ' - Buried Services- excavating within the 500mm safety zone'.
    • General excavation procedures are also covered by ' - Excavations'.
    • Always obtain your PTBG before starting any digging work.
    From the source document(11 clauses)

    5.3ExcavationsEditedAdded

    5.3.1EditedAdded

    The Contracts Manager shall ensure that all excavation and ground-breaking activities are supervised by authorised, competent personnel and carried out in accordance with S&G 001 and S&G 008.

    5.3.2EditedAdded

    Permit to Break Ground (PTBG) is required for all such activities, in accordance with: S&G 001- Buried Services S&G 001a - Buried Services- excavating within the 500mm safety zone, and S&G 008 - Excavations

    5.3.3EditedAdded

    Permit writers and issuers shall hold the competencies specified in S&G 001. Prior to breaking ground, the Delivery Team shall obtain current service drawings from the SHEQ Department and verify their accuracy.

    5.3.4EditedAdded

    The Delivery Team shall produce a PTBG Part A (Form CP6-F33), and all personnel involved shall be briefed and sign the permit. Utilities shall be identified and clearly marked using utility drawings, as-builts, CAT & Genny scans, and trial holes. The CAT & Genny shall be fully calibrated, used in all four modes (Power, Radio, Avoidance, and Genny), and operated by trained personnel.

    5.3.5EditedAdded

    Flame Retardant / ARC Protection clothing shall be worn in accordance with S&G 001. The Delivery Team is responsible for ensuring that all identified utilities are recorded on the PTBG, including depths, and accurately documented on the as-built drawings.

    5.3.6EditedAdded

    The site shall be zoned based on utility records, with zones designated as Red (high risk) or Green (low risk). The site zones may change throughout the lifecycle of the project as new utilities are installed, or more accurate records are produced.

    5.3.7EditedAdded

    When planning the main works, the Delivery Team shall review PTBG Part A and prepare PTBG Part B using (Form CP6-F34). No mechanical excavation is permitted within 500mm of known utilities; vacuum excavation or hand digging shall be undertaken.

    5.3.8EditedAdded

    The permit issuer shall brief all personnel and obtain signatures. The CAT & Genny shall be used prior to and during excavation in all modes. Upon completion, any newly identified utilities shall be recorded, and the PTBG closed out by the issuer.

    5.3.9EditedAdded

    Permits are valid for a maximum of seven days and shall not be extended. If an excavation remains open beyond seven days, an excavation inspection (Form CP6-F22) shall be completed by the Delivery Team.

    5.3.10EditedAdded

    Where a Vacuum Excavator is being used and BCE provide a second person (Form CP6-F65), Vac-Ex Supporting Personnel Authorisation will be used to ensure emergency shut down procedures have been briefed.

    Documents you'll need

    5.4 People Plant Interface (PPI)

    Traffic Management at Our Sites: What You Need to Know

    Our Contracts Manager is responsible for making sure we have a clear plan for managing traffic on all our sites. This isn't just about vehicles; it also covers how people and machinery interact safely. This plan, called a Traffic Management Plan (TMP), must be developed, put into action, and shared with everyone on site.

    Why is this so important? It helps prevent accidents and ensures everyone's safety. The TMP is guided by several key standards:

    • – Traffic Management: This covers general rules for managing traffic.
    • – Mobile Plant Safety: This focuses on the safe operation of mobile plant and machinery.
    • – Plant/Vehicle Marshall (Banksman): This details the role and responsibilities of Banksmen in guiding plant and vehicles.

    If you have any questions or need to see the TMP for your site, please speak to your supervisor or the Contracts Manager. Your understanding and cooperation are vital for a safe working environment.

    Key points

    • A Traffic Management Plan (TMP) is essential for all sites and must be developed, implemented, and communicated.
    • The Contracts Manager is responsible for ensuring the TMP meets all required standards.
    • The TMP governs how people and plant/vehicles interact safely on site.
    • Key standards informing the TMP include , , and .
    From the source document(5 clauses)

    5.4People Plant Interface (PPI)EditedAdded

    No text in source for this clause.

    5.4.1EditedAdded

    The Delivery Team is responsible for effectively managing the PPI. This involves planning, assessing, and controlling risks through the implementation of clear site-specific Traffic Management Plans (TMPs). The Delivery Team shall also ensure plant operator competence, enforce exclusion zones, and monitor compliance.

    5.4.2EditedAdded

    The Contracts Manager shall ensure that a TMP is developed, implemented, and communicated in accordance with the requirements of:

    S&G 012 – Traffic Management.

    S&G 018 – Mobile Plant Safety.

    S&G 038 – Plant/Vehicle Marshall (Banksman).

    5.4.3EditedAdded

    The TMP shall also specify where trained and competent plant / vehicle marshals are required, based on a risk assessment.

    5.4.4EditedAdded

    The Delivery Team shall enforce the “thumbs up” signal rule on site and include this in the site induction and reinforce during daily briefings.

    Documents you'll need

    5.5 Confined Spaces

    If your work involves entering a confined space (like tanks, pits, manholes, chambers or vaults), you must follow the Confined Space Procedure and the guidance in Confined Spaces. This is crucial for your safety and the safety of your team.

    Before anyone enters, the work must be planned with a task-specific Risk Assessment and Method Statement (logged on the RAMS Register) and a Point of Work Risk Assessment (POWRA) completed at the location. Atmospheric hazards must be controlled in line with Gas Safety.

    Entry is only authorised under a Confined Space Permit to Work, issued and signed off by a competent Permit Issuer in line with Permits to Work, and recorded on the Permit Register. Only trained and authorised individuals can supervise, enter, or act as top-man/rescue.

    Remember, proper ventilation, continuous atmospheric monitoring, communications, and a written rescue plan are non-negotiable. Your safety is our priority. If in doubt, do not enter.

    Key points

    • Always follow CP6: SHEQ  for any confined space entry.
    • Complete forms , , and before entry.
    • Only trained and authorized personnel can supervise or enter confined spaces.
    • Ensure proper ventilation, atmospheric monitoring, and rescue plans are in place.
    From the source document(5 clauses)

    5.5Confined SpacesEditedAdded

    No text in source for this clause.

    5.5.1EditedAdded

    he Delivery Team shall ensure that all entries into confined spaces are managed in accordance with the Confined Spaces Regulations 1997 and S&G 003 – Confined Spaces.

    5.5.2EditedAdded

    The Delivery Team shall produce a Confined Space Permit to Work using (Form CP6-F33), and all personnel involved shall be briefed and sign the permit.

    5.5.3EditedAdded

    Calibration records for the gas monitor, escape sets and rescue equipment are to be included with the permit.

    5.5.4EditedAdded

    The Contracts Manager is responsible for ensuring that all confined space work is supervised and only carried out by competent and authorised personnel.

    Documents you'll need

    5.6 Working at Height

    Working at Height: Your Safety Guide

    Any work where a person could fall and injure themselves is working at height — this includes scaffolds, MEWPs, ladders, roofs, edges of structures and excavations. Follow Working at Height at all times.

    Plan the task with a Risk Assessment, Method Statement and confirm controls on site with a Point of Work Risk Assessment (POWRA). Where the work is high-risk (e.g. fragile roofs, edge work without collective protection, or bespoke access) a Permit to Work at Height must be issued and logged on the Permit Register.

    Access equipment must be inspected and recorded:

    • Scaffolding must be inspected by a competent person before first use, every 7 days, after alteration, damage or adverse weather — record on Working at Height Inspection and the scaffold's Temporary Works Safety Checklist (Scaffold/Fences).
    • MEWPs, podiums, ladders and harnesses must be pre-use checked and in date for thorough examination.

    Excavations as working at height: make sure there's a safe way in and out, edges are protected, and for excavations deeper than 2.5m, proper fall protection and rescue equipment are in place. If you're in an excavation deeper than 1.5m you must wear a safety harness to allow quick rescue.

    Always prioritise collective protection (edge protection, nets) over personal protection (harnesses), and never work at height alone without a rescue plan.

    Key points

    • Always provide safe access and egress for excavations.
    • Ensure edge protection is in place for all excavations.
    • For excavations deeper than 2.5 meters, install appropriate fall protection and rescue systems.
    • Wear a safety harness in any excavation deeper than 1.5 meters for emergency recovery.
    From the source document(1 clause)

    5.6Working at HeightEditedAdded

    5.6.1 The Delivery Team shall ensure that all working at height is planned, managed and undertaken by competent persons in accordance with S&G 010 Working at Height.

    5.6.2 When undertaking activities such as scaffold erection or working from a Mobile Elevated Work Platform (MEWP), a Working at Height Permit (Form CP6-F38) shall be issued by the Delivery Team, and all personnel involved shall be briefed and sign the permit.

    5.6.3 Working at height also includes entry into excavations. Therefore:

    Safe access and egress shall be provided.

    Edge protection shall be in place.

    For excavations deeper than 2.5 metres, appropriate fall protection and rescue systems shall be installed.

    A safety harness shall be worn in any excavation deeper than 1.5 metres to enable safe and efficient recovery in case of an emergency.

    Documents you'll need

    5.7 Working underneath or adjacent to Overhead Power Lines (OHPL)

    Working near overhead power lines (OHPL)? Your safety is paramount. Follow Overhead Services & Structures at all times.

    Plan the work with a task-specific Risk Assessment and Method Statement, and complete a Point of Work Risk Assessment (POWRA) on site before starting. Identify clearances and record them on Statement of Clearances for Work Near Overhead Power Lines.

    Before any work underneath or adjacent to OHPL begins, an Overhead Services Permit must be issued and signed off by a competent Permit Issuer, logged on the Permit Register. Where isolation has been arranged with the DNO, a Electrical Permit to Work is also required.

    Always ensure there is a designated Banksman and a safe system of work (SSOW) in place. The minimum safe clearance distance is 6 metres; if work needs to happen closer, a detailed SSOW must be developed and approved by the responsible manager and the line owner.

    Never forget to use your site's lockout/tagout procedure where applicable to prevent accidental energisation. Stay safe.

    Key points

    • Always get a Permit to Work (PTW) before working near overhead power lines (OHPL).
    • Maintain a minimum safe clearance of 6 metres from OHPL.
    • Implement a Safe System of Work (SSOW) and use a Banksman, as detailed in .
    • If working closer than 6 metres, a detailed, approved SSOW is required.
    • Follow the lockout/tagout procedure () when necessary.
    From the source document(1 clause)

    5.7Working underneath or adjacent to Overhead Power Lines (OHPL)EditedAdded

    5.7.1 The Delivery Team is responsible for ensuring that all activities comply with HSE Guidance Note GS6 and S&G 002 to ensure that no personnel, plant, materials, or equipment come into contact with overhead services or structures. Prior to any work near OHPL, planning and risk assessments shall be completed by the Delivery Team in accordance with the requirements set out in S&G 002.

    5.7.2 The Delivery Team is responsible for determining the voltage and height of OHPL to establish appropriate exclusion zones and safe working clearances. The Contracts Manager shall ensure that only trained personnel carry out height measurements using non-contact devices. The Distribution Network Operator (DNO) shall be contacted first; if they are unavailable, an in-house assessment shall be arranged through the SHEQ Advisor.

    5.7.3 A written Statement of Clearance shall be obtained by the Delivery Team from the DNO, a competent in-house assessor using (Form CP6-F40), or an independent specialist, before commencing work near OHPL.

    5.7.4 The Delivery Team shall produce an Overhead Service Permit (Form CP6-F39), and all personnel involved shall be briefed and sign the permit for all work under or near OHPL. The permit shall include safe working clearances, relevant plans, drawings, and risk control measures and shall be completed by a competent person.

    Documents you'll need

  6. 6Emergency Preparedness and Response1 part

    6 Emergency Preparedness and Response

    This section details our procedures for preparing for and responding to emergencies. It ensures we have plans in place to handle incidents safely and effectively, protecting both our people and the environment — including fires, medical emergencies, chemical spills, environmental releases, and severe weather.

    Every site must have a current Emergency Response Plan in place before work starts, communicated to everyone at induction ( Site Induction Record) and reinforced through Daily Briefing Record. Fire risks must be assessed and controlled through the Fire Risk Assessment and Fire Plan, and any visitors must be accounted for via the Visitor Register.

    Follow the supporting guidance: Emergency Preparedness for general response, Fire Prevention for fire-specific controls, and Storage of Fuels, Oils and Chemicals for spill prevention.

    Familiarise yourself with emergency exits, assembly points and who to contact. Always follow instructions from emergency responders or appointed personnel. Your understanding and adherence to these procedures are crucial for everyone's safety.

    Key points

    • This section outlines our emergency preparedness and response procedures for all potential incidents.
    • Know your emergency exits, assembly points, and key emergency contacts.
    • Always follow instructions from emergency responders and designated personnel.
    • Use Emergency Response Plan and Fire Risk Assessment and Fire Plan; follow and .
    • Your active participation in emergency procedures is vital for collective safety.
    From the source document(1 clause)

    6Emergency Preparedness and ResponseEdited

    6.1.1 The Delivery Team shall ensure that they have adequate processes in place to effectively manage any emergency that may occur on site. The Delivery Team shall produce an emergency plan for the project (Form CP6-F14) and display it prominently on site. The contents of the plan shall be briefed to all on site at the point of induction to enable them to respond quickly and efficiently should an emergency arise.

    6.1.2 The Delivery Team shall carry out a fire risk assessment and produce a fire plan (Form CP6-F16) for the project and shall communicate this to all personnel on site and display within the site accommodation. The fire risk assessment shall include the charging of electric vehicles where this takes place on site.

    6.1.3 Some emergency procedures require practice emergency drills, these should be carried out at periods prescribed by law or at intervals appropriate to the seriousness of the potential incident. A documented record shall be maintained of all emergency drills detailing the effectiveness of the arrangements.

    6.1.4 S&G 011 provides further guidance on Emergency Preparedness.

    Documents you'll need

  7. 7Inspections - Monitoring, measurement, analysis and performance evaluation6 parts

    7.1 Safety, Health, Environmental & Quality Inspection

    Under clause 7.1.1, the Delivery Team must carry out a general site Safety, Health, Environmental & Quality inspection on a weekly basis.

    Use Safety, Health, Environment and Quality Inspection to record:

    • A description of the works being undertaken
    • Any health, safety and environmental risks
    • Any quality issues
    • Details of remedial actions to be taken

    Inspection photographs must be taken to record the condition of the site.

    Where the weekly SHEQ walk identifies open excavations, also complete Safety Inspection – Excavation for those excavations in line with Section 7.2.

    Supporting guidance: Hazard Identification & Risk Assessment for identifying issues during inspection.

    Key points

    • Clause 7.1.1 requires a weekly general SHEQ site inspection by the Delivery Team.
    • Record findings on Form Safety, Health, Environment and Quality Inspection.
    • Use Form Safety Inspection – Excavation alongside where excavations are present (see Section 7.2).
    • Capture works description, SHEQ risks, quality issues and remedial actions.
    • Take inspection photographs to record site condition.
    • Refer to Hazard Identification & Risk Assessment for supporting guidance.
    From the source document(1 clause)

    7.1Safety, Health, Environmental & Quality InspectionEditedAdded

    7.1.1 The Delivery Team shall carry out a general site safety and environmental inspection on a weekly basis. The Safety, Health, Environment and Quality Inspection (Form CP6-F22) will record the description of the works being undertaken, any matters that give rise to health, safety and environmental risks, quality issues as well as details of any remedial actions to be taken. Inspection photographs shall be taken to record the condition of the site.

    Documents you'll need

    7.2 Site Inspections – Excavation

    Under clause 7.2.1, the Delivery Team must inspect all excavations that have remained open for seven days or more, or following events such as inclement weather, nearby heavy plant movements, or any activity that may compromise excavation stability.

    Record the condition of the excavation, any identified health and safety risks, and the required remedial actions on Safety Inspection – Excavation.

    Supporting guidance: Excavations for general controls and inspection standards. (Note: day-to-day permit and pre-entry controls for excavations are covered in Section 5.3.)

    Key points

    • Clause 7.2.1 requires inspection of excavations open for 7 days or more.
    • Inspect after events affecting stability (weather, nearby heavy plant, etc.).
    • Record findings on Form Safety Inspection – Excavation.
    • Refer to Excavations for supporting guidance.
    From the source document(1 clause)

    7.2Site Inspections – ExcavationEditedAdded

    7.2.1 The Delivery Team shall carry out inspections of all excavations that have remained open for seven days or more, or following events such as inclement weather, nearby heavy plant movements, or any activity that may compromise excavation stability. The condition of the excavation, any identified health and safety risks, and required remedial actions shall be recorded using the Safety Inspection – Excavation form (Form CP6-F23).

    Documents you'll need

    7.3 Site Inspections – Work at Heights

    Under clause 7.3.1, all locations where work at height is being carried out must be inspected at least weekly to confirm no new risks have arisen, all control measures are in place and adequate, and all plant and equipment is inspected and fit for purpose.

    Under clause 7.3.2, all scaffolding must be inspected by a competent person (generally appointed from the scaffolding Subcontractor by the Delivery Team):

    • Before it comes into use for the first time
    • Weekly thereafter
    • After any alteration
    • Following any damage incident
    • After adverse weather

    Under clause 7.3.3, the competent person shall use their own inspection form or tag. Where one is not available, use Site Inspection – Work at Height (Scaffolding) to document the condition of the scaffolding, identified risks and remedial actions. All completed inspection forms (proprietary or ) must be retained on site.

    Supporting guidance: Working at Height.

    Key points

    • Clause 7.3.1 — weekly inspection of all work-at-height locations.
    • Clause 7.3.2 — scaffolding inspected by a competent person before first use, weekly, after alteration, damage or adverse weather.
    • Clause 7.3.3 — use where the competent person has no proprietary form/tag.
    • All completed inspection forms must be retained on site.
    • Refer to Working at Height for supporting guidance.
    From the source document(1 clause)

    7.3Site Inspections – Work at HeightsEditedAdded

    7.3.1 All locations where work at height is being carried out shall be inspected at least weekly to ensure that no new risks have occurred, all control measures are in place and adequate, and that all plant and equipment is inspected and fit for purpose. The Inspection (Form CP6-F23) shall record any risks identified and any control measures needed.

    7.3.2 All scaffolding shall be inspected by a competent person (generally appointed from the scaffolding Subcontractor by the Delivery Team):

    Before it comes into use for the first time:

    Weekly;

    After any alteration;

    Following any damage incident;

    After adverse weather.

    7.3.3 The competent person shall use their own inspection form or tag. Should one not be available, the Site Inspection Work at Height form (Form CP6-F24) shall be used to document the condition of the scaffolding, any identified health and safety risks, and the required remedial actions. All completed forms, whether proprietary or (Form CP6-F24), shall be retained on site.

    Documents you'll need

    7.4 Site Inspections – Highway or Public Area Works

    Under clause 7.4.1, all works on or adjacent to public highways or public areas must be inspected daily to confirm that fencing, signage, cones, lighting and other traffic / pedestrian safety measures are in place and adequate, and to note any trip or other hazards.

    Under clause 7.4.2, use Site Inspection – Highway or Public Area Works to record each daily inspection and detail any new hazards identified together with the control measures undertaken.

    Under clause 7.4.3, inspection photographs must be taken to record the measures in place before the site is vacated.

    Supporting guidance: Traffic Management.

    Key points

    • Clause 7.4.1 — daily inspection of highway / public-area works (fencing, signage, cones, lighting, pedestrian safety).
    • Clause 7.4.2 — record each daily inspection on Site Inspection – Highway or Public Area Works.
    • Clause 7.4.3 — take inspection photographs before vacating the site.
    • Refer to Traffic Management for supporting guidance.
    From the source document(1 clause)

    7.4Site Inspections - Highway or Public Area WorksEditedAdded

    7.4.1 All works on or adjacent to public highways or public areas shall be inspected daily to ensure that the fencing, signage, cones, lighting and other traffic / pedestrian safety measures are in place and adequate. The inspection should also note any potential trip or other hazards.

    7.4.2 The Site Inspection – Highway or Public Area Works Form (Form CP6-F25) shall be used to record each daily inspection and to detail any new hazards identified together with the control measures undertaken.

    7.4.3 Inspection photographs shall be taken to record the measures that have been put into place before the site is vacated.

    Documents you'll need

    7.5 Plant Inspections

    Initial Plant Inspection (clauses 7.5.1–7.5.2)

    All items of plant — whether hired externally, supplied by the Breheny Plant Department, or brought to site by a Subcontractor — must be inspected as soon as delivered to site, with the condition recorded on Initial Plant Inspection Report (or a Subcontractor's suitable equivalent). The completed form is held in the project workspace on the EDMS, and a copy sent to the hirer and Plant Hire Department where plant is delivered with pre-existing damage.

    Daily Plant Inspections (clause 7.5.3)

    The Delivery Team must ensure all plant and equipment is inspected daily and the result formally recorded on the machine-specific Daily Plant and Equipment Inspection Record:

    • – 360° Excavator Inspection Record
    • – Forward Tipping Dumper Inspection Record
    • – Roller Inspection Record
    • – Telehandler Inspection Record
    • – Forklift Inspection Record
    • – General Plant Inspection Record

    Subcontractors may use their own suitable equivalent daily inspection forms.

    Non-Ride-On Plant / PUWER (clause 7.5.4)

    All non-ride-on operated plant (PUWER checks) must be inspected weekly when in use and the result formally recorded on Non-Ride-On Plant Inspection Record.

    Supporting guidance: Mobile Plant Safety.

    Key points

    • Clause 7.5.1–7.5.2 — record initial on-delivery plant inspection on (or Subcontractor equivalent).
    • Clause 7.5.3 — daily inspection on machine-specific forms (360° excavator), F27 (FTD), F28 (roller), F29 (telehandler), F30 (forklift), F31 (general plant).
    • Subcontractors may use their own suitable equivalent daily inspection forms.
    • Clause 7.5.4 — non-ride-on plant (PUWER) inspected weekly when in use, recorded on .
    • Refer to Mobile Plant Safety for supporting guidance.
    From the source document(1 clause)

    7.5Plant InspectionsEdited

    7.5.1 All items of plant whether hired externally, from the Breheny Plant Department or brought onto site by a Subcontractor, are to be inspected as soon as delivered to site and the condition recorded.

    7.5.2 The Initial Plant Inspection Report (Form CP6-F18), or a Subcontractor’s suitable equivalent is to be used. The completed form is to be held in the project workspace on the EDMS, and a copy sent to the hirer and Plant Hire Department should plant be delivered with pre-existing damage.

    7.5.3 The Delivery Team shall ensure that all Plant and Equipment is inspected daily and the result of the inspection formally recorded on the Daily Plant and Equipment Inspection Record, which is machine specific

    • Form CP6-F26 - 360⁰ Excavator Inspection Record
      • Form CP6-F27 - Forward Tipping Dumper Inspection Record
      • Form CP6-F28 - Roller Inspection Record
      • Form CP6-F29 - Telehandler Inspection Record
      • Form CP6-F30 - Forklift Inspection Record
      • Form CP6-F31 - General Plant Inspection Record

    Where Subcontractors have their own suitable equivalent daily inspection form, its use is permitted.

    7.5.4 The Delivery Team shall ensure that all Non-Ride-On Operated Plant (PUWER checks) is inspected weekly when in use and the result of the inspection formally recorded on the Non-Ride on Plant Inspection Record (Form CP6-F19).

    Documents you'll need

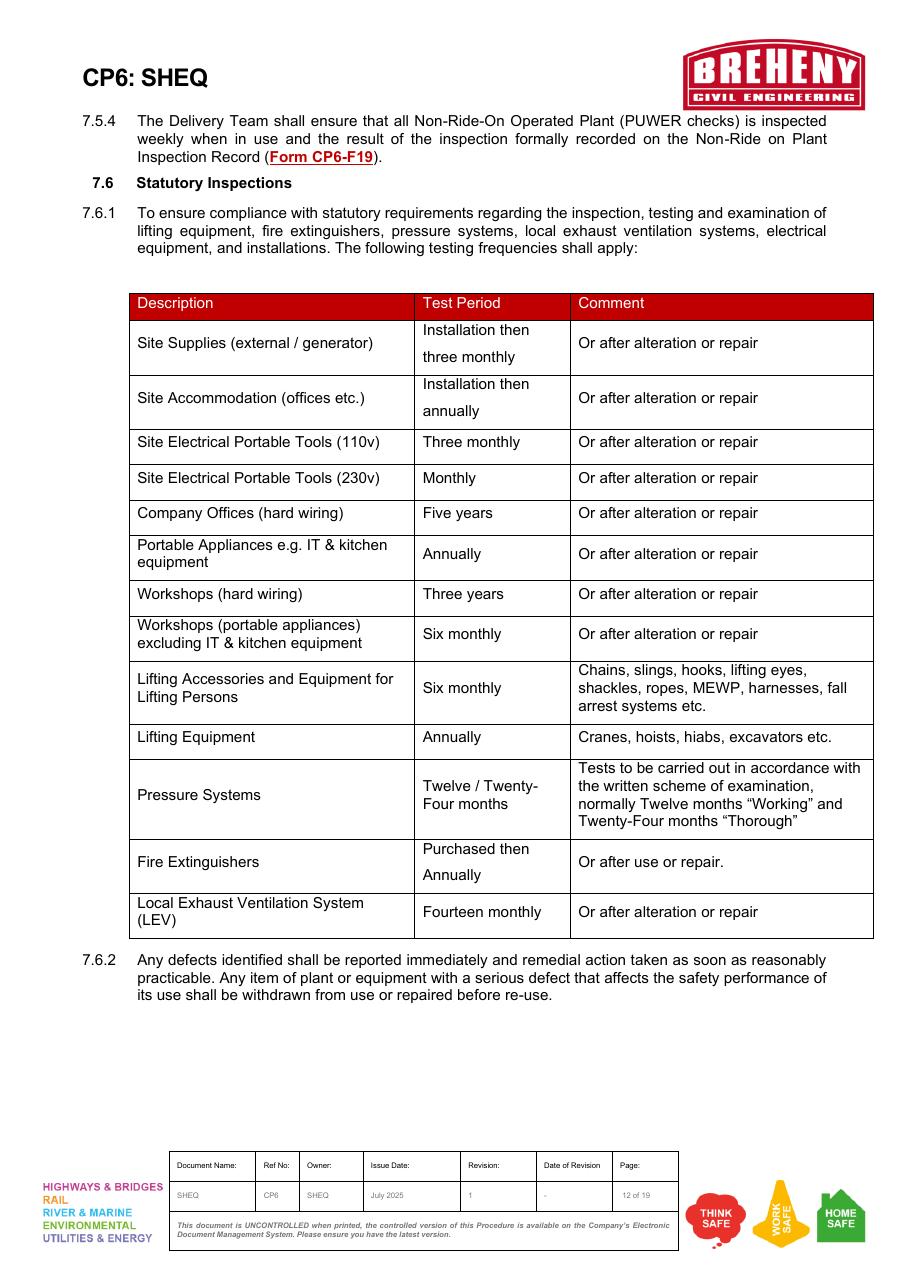

    7.6 Statutory Inspections

    Under clauses 7.6.1–7.6.2, statutory inspection, testing and examination of lifting equipment, fire extinguishers, pressure systems, local exhaust ventilation, electrical equipment and installations must be carried out at the frequencies below. Any defects identified must be reported immediately and remedial action taken as soon as reasonably practicable; any item with a serious defect affecting safety performance must be withdrawn from use or repaired before re-use.

    Inspection frequencies:

    • Site Electricals (portable tools, site supplies, accommodation wiring): monthly to annually, or after any changes/repairs. Hard wiring in main offices: every five years.
    • Portable Appliances (IT, kitchen gear): annually.
    • Workshops: hard wiring every three years; portable appliances (excluding IT/kitchen) every six months.
    • Lifting Equipment & Accessories: accessories for lifting people (e.g. harnesses) every six months; general lifting equipment (cranes, hoists) annually.
    • Pressure Systems: typically 12-month 'Working' tests and 24-month 'Thorough' tests, per the written scheme of examination.
    • Fire Extinguishers: annually, or after any use/repair.
    • Local Exhaust Ventilation (LEV): every 14 months, or after changes/repairs.

    Test and examination certificates must be retained in the Site File. Supporting guidance: Fire Prevention for fire extinguisher controls and the wider statutory inspection regime managed by the Plant and SHEQ teams.

    Key points

    • Clause 7.6.1 sets statutory inspection frequencies for electrical, lifting, pressure, fire and LEV equipment.
    • Lifting accessories for personnel inspected every 6 months; general lifting equipment annually.
    • Pressure systems: 12-month Working and 24-month Thorough tests per written scheme of examination.
    • Fire extinguishers checked annually or after use/repair; LEV every 14 months or after change/repair.
    • Clause 7.6.2 — defects reported immediately; serious defects withdraw item from use until repaired.
    • Retain all test and examination certificates in the Site File.
    From the source document(1 clause)

    7.6.1Statutory InspectionsEdited

    7.6.1 To ensure compliance with statutory requirements regarding the inspection, testing and examination of lifting equipment, fire extinguishers, pressure systems, local exhaust ventilation systems, electrical equipment, and installations. The following testing frequencies shall apply: (See Table below).

    7.6.2 Any defects identified shall be reported immediately and remedial action taken as soon as reasonably practicable. Any item of plant or equipment with a serious defect that affects the safety performance of its use shall be withdrawn from use or repaired before re-use.

    Documents you'll need

  8. 8Communication and Consultation2 parts

    8.1 Toolbox Talks

    Toolbox Talks are short, focused safety meetings held on-site to discuss hazards, risks, and safe work practices relevant to the day's tasks or specific site issues. These talks are a crucial part of our safety management system, ensuring everyone understands potential dangers and how to prevent accidents.

    Your supervisor or a competent person will lead these informal discussions, encouraging open communication and questions. Topics can range from specific job hazards to new equipment safety or lessons learned from incidents. Participation is mandatory, and attendance is recorded using form (Tool Box Talk & Training Attendance). The content of the talk is documented on form (Toolbox Talk Register). These regular check-ins help us all stay safe and informed.

    Key points

    • Toolbox Talks are short on-site safety meetings led by supervisors or competent persons.
    • They cover daily hazards, risks, and safe work practices relevant to current tasks.
    • Participation is mandatory, and attendance is recorded using form .
    • The content of each talk is documented using form .
    • These regular talks ensure effective communication of safety information and help prevent accidents.
    From the source document(1 clause)

    8.1Toolbox TalksEditedAdded

    8.1.1 The Delivery Team is responsible for ensuring that all personnel on site, including Subcontractors, receive a Toolbox Talk (TBT) at least every two weeks. Each TBT should address topics relevant to the specific actions or concerns of the project and should last approximately thirty minutes.

    8.1.2 The Delivery Team may use the BCE library of TBTs or develop project-specific talks as appropriate. TBTs shall also include Environmental and Quality topics, where relevant to the site.

    8.1.3 A Toolbox Talk / Training Attendance Record (Form CP6-F21) shall be completed for every session and sent to the SHEQ Department.

    Documents you'll need

    8.2 Daily Briefing

    Hi team,

    Our daily briefing (as per CP6: SHEQ 8.2) is a quick but crucial chat to keep everyone safe and informed. The Delivery Team runs the briefing using the Daily Briefing Record (Form ), which everyone present signs — it also doubles as the on-site register for operatives and subcontractors.

    Here's why we do it:

    It's our chance to talk about immediate safety risks for today's work and confirm we've got the right controls in place. We'll also highlight any residual hazards, make sure everyone knows what's planned for the day or coming days, and double-check that everyone is capable, fit, and healthy for their roles.

    We'll also use this time to discuss any urgent safety concerns, changes to staff or equipment, and share important lessons learned from recent incidents or near misses, whether on our site or across the wider company. It's an open forum — ask questions and raise concerns; participation is documented as part of ongoing consultation under the BCE Safety Management System.

    Any visitors, company personnel or trade reps (excluding delivery drivers) who aren't at the Daily Briefing must sign in and out using the Visitor Register (Form ), which is displayed in the site office. This applies even if the Client or Principal Contractor runs their own visitors' book.

    Key points

    • Daily briefings are run by the Delivery Team using the Daily Briefing Record (Form ), signed by everyone present.
    • Form also serves as the on-site register for operatives and subcontractors.
    • Briefings communicate short-term safety risks, controls and residual hazards for the day's planned work.
    • Competency, fitness and health of personnel are confirmed at the briefing.
    • Urgent safety issues, changes in personnel/plant/equipment, and lessons learned from incidents and near misses are shared.
    • Worker participation is encouraged and documented as ongoing consultation under the BCE Safety Management System.
    • Visitors, company personnel and trade reps not present at the Daily Briefing must sign in and out using the Visitor Register (Form ), displayed in the site office.
    • Toolbox Talk attendance is recorded using form (Tool Box Talk & Training Attendance) and the talk content is logged on form (Toolbox Talk Register) — referenced here for cross-link with Section 8.1.
    From the source document(1 clause)

    8.2Daily BriefingEditedAdded

    8.2.1 The Delivery Team shall ensure that daily briefings are conducted using (Form CP6-F51) and signed by all personnel present.

    8.2.2 The purpose of the briefing is to:

    Communicate short-term safety risks and controls related to planned work.

    Ensure immediate actions are taken to maintain a safe working environment.

    Make workers aware of residual hazards and the tasks planned for the day or upcoming days.

    Confirm that all personnel are competent, fit, and healthy to undertake their duties.

    8.2.3 Daily briefings shall also address:

    Any urgent safety issues that have arisen.

    Changes in personnel, plant, or equipment.

    Relevant learning points from incidents or near misses, either on-site or within the wider business.

    8.2.4 The daily briefing provides an opportunity for personnel to ask questions, raise concerns, and contribute to the improvement of site safety. Worker participation is encouraged and documented as part of ongoing consultation under the BCE Safety Management System.

    8.2.5 The Daily Briefing (Form CP6-F51) serves as a register for operatives and Subcontractors on site.

    8.2.6 The Delivery Team shall be responsible for ensuring that all visitors, including company personnel and trade representatives (excluding delivery drivers) that are not present in the Daily Briefing to sign in and out of the site using the Company’s Visitors Register (Form CP6-F15). The register shall be displayed prominently in the site office. This procedure shall be followed even if the Client or Principal Contractor operates their own site visitors’ book.

    Documents you'll need

  9. 9Competence, Skills Certification and Training Requirements1 part

    9 Competence, Skills Certification and Training Requirements

    To ensure everyone on site has the right skills and training, CP6: SHEQ 9.1 outlines what cards and certificates you need.

    Managers must have a management level competence card (like CSCS) and at least one of these: a CITB SMSTS certificate, IOSH Managing Safely, or an equivalent qualification.

    Supervisors need a supervisor level competence card (like CSCS) and at least a CITB SSSTS certificate or an equivalent.

    All Operatives are required to have a valid skills card (such as CPCS, CSCS, or NPORS) that matches the work they do. We also accept competency cards from other recognised CSCS partner schemes.

    Key points

    • Managers require a management level competence card (CSCS) and either CITB SMSTS, IOSH Managing Safely, or an equivalent certificate.
    • Supervisors need a supervisor level competence card (CSCS) and a CITB SSSTS certificate or an equivalent.
    • Operatives must possess a valid skills card (CPCS/CSCS/NPORS) relevant to their specific tasks.
    • BCE formally accepts competency cards issued by recognised CSCS partner schemes.
    From the source document(4 clauses)

    9CompetencyEdited

    9.1.1 The Delivery Team shall ensure that all personnel (including employees, Subcontractors, agency workers, and visitors) performing work under the Company’s control are competent, based on appropriate education, training, skills, and experience, to carry out their assigned tasks safely and without risk to health or the environment.

    9.1.2Managers will hold the following competencies:

    • Management level competence card (CSCS etc.), and one of the following as a minimum;
      • CITB Site Managers Safety Training Scheme (SMSTS) certificate, IOSH Managing Safely, or equivalent

    9.1.3Supervisors will hold the following competencies:

    • Supervisor level competence card (CSCS etc.), and;
      • CITB Site Supervisors Safety Training Scheme (SSSTS) certificate or equivalent as a minimum.
      • Operatives are required to possess a valid skills card (CPCS/CSCS/NPORS) relevant to the task they perform. BCE also accepts competency cards issued by recognised CSCS partner schemes.

    9.2TrainingEditedAdded

    9.2.1 Contracts Managers and Heads of Departments shall be responsible for the identification of an individual’s training needs and the implementation of any remedial training, in accordance with the Company Training Matrix.

    9.2.2 To fully support our “Think Safe, Work Safe, Home Safe” Behavioural Change Programme, all Breheny Delivery Teams, Operatives and long-term Sub-contractors are required to attend Breheny Think Safe, Work Safe, Home Safe Workshops.

    9.2.3 Employees may need training to operate most types of plant and equipment. This may be CPCS, CSCS Accredited NPORS, or other recognised training.

    9.2.4 No person should be considered for training to operate wheeled or tracked mobile plant on the public highway unless they are a holder of a driving licence for the class of vehicle being operated.

    9.2.5 No person will be considered for training unless they have reached the age of 18 and a satisfactory medical report has been provided by the Occupational Health Consultant.

    9.2.6 Under 18’s who are undertaking a BCE approved Plant Operative’s Apprenticeship, such as the CITB’s Plant Operation (Civil Engineering Plant and Construction Plant), will be permitted to operate mobile plant on BCE projects, subject to a suitable and sufficient risk assessment being undertaken with appropriate control measures in place and a competent mentor assigned.

    9.2.7 Where works are undertaken on the public highway, the age restrictions on licence categories will take precedence. Clients may also restrict the age at which persons can operate mobile plant and work on site.

    9.2.8 Training shall also be carried out as necessary following the issue of new procedures or amendments to any of the Company’s existing documents or procedures.

    9.2.9 Training shall be provided by internal or external trainers who are qualified or professionally competent to carry out such training.

    9.2.10 Training needs will be reviewed on an ongoing basis and formally considered as part of the annual staff performance review or Employee “Job Chat” discussions. Employees may request training through their Department Manager or Delivery Team in the interim. Applications for training must be submitted through the Training Department and require authorisation from a Contracts Manager or Department Manager.

    9.2.11 The Training Department will maintain a training database for all Company employees. This will record planned training needs, training received and the validity of any training certification for all employees.

    9.2.12 Any person found incapable of performing their duties due to insufficient training, lack of experience or following an incident investigation, shall receive appropriate training within a given time scale. This will be reviewed with their Contracts Manager or Department Manager to ensure that training has been suitable and sufficient, and has met their needs and that of the Company.

    9.2.13 The effectiveness of training is evaluated through supervision, site inspections, audits, incident and near miss review, and performance monitoring, with outcomes used to confirm ongoing competence or to identify the need for further training or corrective action.

  10. 10Environment5 parts

    10.1 Identification and Evaluation of Environmental Aspects and Impacts

    Understanding and managing how our site activities affect the environment is crucial. This section of CP6: SHEQ , specifically Section 10.1, outlines the process for identifying all our environmental aspects (like waste generation or energy use) and their potential impacts (e.g., pollution or resource depletion), in line with – Aspects & Impacts.

    We regularly review all activities, products, and services, considering both normal and abnormal operations, as well as potential emergencies. This helps us to assess which impacts are significant and need focused management. The findings are documented using the Environmental Aspects & Impacts Register (Form ) and the Significant Aspects & Impacts Evaluation (Form ), which are updated annually or when significant changes occur. By following this procedure, we ensure we're proactively minimising our environmental footprint.

    Key points

    • Section 10.1 sets out how we identify environmental aspects and evaluate their potential impacts across all site activities, in line with – Aspects & Impacts.
    • Reviews cover normal operations, abnormal situations, and reasonably foreseeable emergencies so nothing significant is missed.
    • Significance is judged on factors such as scale, severity, duration, likelihood, and legal or stakeholder implications.
    • Environmental aspects are recorded on the Environmental Aspects & Impacts Register (Form ), and significance is assessed using the Significant Aspects & Impacts Evaluation (Form ).
    • Registers are reviewed annually as a minimum, and whenever activities, products, services, or legal requirements change significantly.
    From the source document(1 clause)

    10.1Identification and Evaluation of Environmental Aspects and ImpactsEditedAdded

    10.1.1.To support effective planning, the Head of ESG shall identify significant environmental aspects and their associated impacts to determine where control or improvement is needed and to set priorities for management action.

    10.1.2 S&G 031 Aspects and Impacts, outlines BCE’s process for identifying, examining, and evaluating all significant environmental impacts, covering normal, abnormal, and emergency conditions.

    10.1.3 Aspects and Impact registers (Form CP6-F74) and (Form CP6-F75) can

    Documents you'll need

    10.2 Environmental Management

    To all site staff, when working on the project, the Delivery Team needs your help to make sure we're looking after the environment properly.

    This means following all the rules and guidelines detailed in the following Standards & Guidance (S&G) documents. It's crucial that we not only put these measures in place, but also keep them up and record everything correctly throughout the entire project.

    The S&Gs you need to be familiar with are:

    • - Storage of Oils & Chemical
    • – Environmental Nuisance
    • – Waste Management
    • – Hazardous Substances
    • – Invasive Non-Native Plants
    • – Working with Flora & Fauna
    • – Emissions to Air

    Your adherence to these standards is essential for protecting the environment.

    In the event of an environmental incident or spill, the Emergency Response Plan () must be followed and completed as required.

    Key points

    • The Delivery Team is responsible for environmental control and protection measures.
    • All measures outlined in the listed Standards & Guidance (S&G) documents must be implemented.
    • These measures need to be maintained and properly documented throughout the project.
    • (Oils & Chemical Storage), (Environmental Nuisance), and (Waste Management) are key documents.
    • Other important S&Gs include (Hazardous Substances), (Invasive Non-Native Plants), (Working with Flora & Fauna), and (Emissions to Air).
    • Use (Emergency Response Plan) to record and respond to any environmental incident or spill.
    From the source document(1 clause)

    10.2Environmental Management Edited

    10.2.1 Environmental controls implemented under CP6 support delivery of environmental objectives defined in CP1 and reviewed through audits, inspections, and management review.

    10.2.2 Operational controls take account of climate‑related risks where relevant, including extreme weather impacts on site activities, pollution control and emergency preparedness.

    10.2.3 The Delivery Team shall ensure that a SHEQ Plan is developed for the project, incorporating both the Environmental Management Plan and the Emergency Response Plan (Form CP6-F14). A hard copy of the SHEQ Plan shall be kept on-site and always remain accessible.

    10.2.4 The Contracts Manager shall ensure the SHEQ Plan remains a live, dynamic document, that is regularly reviewed and updated throughout the project to reflect changes in site conditions, risks, methods, and resources.

    10.2.5 The Delivery Team shall ensure compliance with environmental legislation, regulations, and planning conditions, and ensure all permits, consents, and licences (e.g. waste carrier licence, water discharge consent) are obtained and adhered to.

    10.2.6 The Delivery Team shall be responsible for ensuring that the environmental elements of the Emergency Response Plan are clearly communicated to all personnel during the site induction.

    10.2.7 The Delivery Team shall ensure that all control and protection measures outlined in the Standards & Guidance documents below are implemented, maintained, and properly documented throughout the project.

    S&G 009 - Storage of Oils & Chemical

    S&G 019 – Environmental Nuisance

    S&G 021 – Waste Management

    S&G 022 – Hazardous Substances

    S&G 034 – Invasive Non-Native Plants

    S&G 035 – Working with Flora & Fauna

    S&G 040 – Emissions to Air

    Documents you'll need

    10.3 Waste Management and Duty of Care

    At its core, Waste Management and Duty of Care (Section 10.3 of CP6: SHEQ ) requires the Delivery Team to make sure we produce as little waste as possible on site. Where waste is unavoidable, it must be handled according to the waste hierarchy:

    • Prevention
    • Reuse
    • Recycling
    • Recovery
    • Disposal

    All waste streams must be correctly identified, with the appropriate List of Waste (LoW) codes assigned. Waste must be segregated and handled appropriately, using licensed carriers for transportation and disposal. The Delivery Team must maintain accurate records, including waste transfer notes and consignment documentation, verify the competence and licensing of waste contractors, and ensure that disposal occurs at authorised facilities.

    The Delivery Team shall undertake Duty of Care checks and record them using Form . Where the Client requires a Site Waste Management Plan, the Delivery Team shall prepare and update it using Form .

    Further guidance on waste management is available within – Waste Management.

    Key points

    • Minimise waste on site and follow the waste hierarchy: Prevention, Reuse, Recycling, Recovery, Disposal.
    • Identify all waste streams with the correct List of Waste (LoW) codes; segregate and handle appropriately.
    • Use licensed carriers and authorised facilities; keep waste transfer notes and consignment documentation.
    • Undertake Duty of Care checks and record them using Form .
    • Prepare and update a Site Waste Management Plan using Form where required by the Client.
    • Refer to – Waste Management for further guidance.
    From the source document(1 clause)

    10.3Waste Management and Duty of CareEdited

    10.3.1 The Delivery Team is responsible for ensuring that waste is minimised on site, and that the waste hierarchy is followed:

    Prevention

    Reuse

    Recycling

    Recovery

    Disposal.

    10.3.2 All waste streams shall be correctly identified, with the appropriate List of Waste (LoW) codes assigned. Waste shall be segregated and handled appropriately, using licensed carriers for transportation and disposal. The Delivery Team shall maintain accurate records, including waste transfer notes and consignment documentation, verify the competence and licensing of waste contractors, and ensure that disposal occurs at authorised facilities.

    10.3.3 The Delivery Team shall undertake Duty of Care checks and record them using (Form CP6-F64). Where the Client requires a Site Waste Management Plan, the Delivery Team shall prepare and update using (Form CP6-F63).

    10.3.4 Further guidance on waste management can be found within S&G 021 Waste Management.

    Documents you'll need

    10.4 Energy Management

    For any project lasting over 30 days, we need a Project-Specific Energy Management Plan. This plan must be filled out using Form and included in the project's overall SHEQ Plan.

    This is important because these plans help us manage our main energy uses and directly impact our energy performance indicators (EnPIs). The Energy Management Plan will outline significant energy uses, define ways to reduce energy and improve efficiency, assign who is responsible for energy management on site, and detail how we'll monitor and report our energy use. It also explains what we need to do if we notice unusual or excessive energy consumption.

    Key points

    • Projects over 30 days require a Project-Specific Energy Management Plan.
    • Use Form for the Project-Specific Energy Management Plan, integrating it into the Project SHEQ Plan.
    • The plan identifies significant energy uses and defines reduction measures.
    • It assigns roles and responsibilities for energy management.
    • Monitoring, measurement, and reporting arrangements are specified.
    • Actions for abnormal or excessive energy use are defined.
    From the source document(1 clause)

    10.4Energy ManagementEdited

    10.4.1 Energy Management is addressed within the Company’s Integrated Management System in accordance with CP2 (Corporate Governance) and CP3 (Operational Control).

    10.4.2 The Delivery Team determines plant, site accommodation, equipment and material requirements, in line with CP2 energy management requirements, with ordering through the Plant Department or Buyer as appropriate.

    10.4.3 All projects with a duration exceeding thirty (30) days shall have a Project-Specific Energy Management Plan, prepared using Form CP3-F06 and incorporated within the Project SHEQ Plan. Project and office Energy Management Plans control major energy use and directly influence organisational EnPIs. The Energy Management Plan shall:

    Identify Significant Energy Uses associated with the project;

    Define energy reduction and efficiency measures;

    Assign roles and responsibilities for energy management at project level;

    Specify monitoring, measurement and reporting arrangements; and

    Define actions to be taken in the event of abnormal or excessive energy use.

    10.4.4 The Energy Management Plan shall be reviewed and approved by the Contracts Manager or their nominated representative and shall be implemented throughout the duration of the project.

    10.4.5 The Delivery Team shall ensure that the requirements of the Energy Management Plan are implemented on site and that energy performance considerations are communicated to relevant personnel through site inductions, briefings and toolbox talks where appropriate.

    10.4.6 Abnormal or unexpected energy use identified through monitoring or inspection is reviewed to determine whether it is attributable to planned activities, programme requirements or other legitimate operational factors. Where energy use is identified as avoidable, uncontrolled or not aligned with agreed energy management controls, it is investigated and managed in accordance with CP3 – Management of Non‑Conforming Outputs and Improvement.

    10.4.7 Initial review of abnormal or unexpected energy use is undertaken by the Delivery Team to determine operational justification. SHEQ oversight is applied where escalation, trend analysis or corrective action is required.

    Documents you'll need

    10.5 Carbon Management

    Hi team,

    Our Carbon Management procedure (Section 10.5 of CP6: SHEQ ) is all about effectively managing and reducing our carbon emissions across all our operations and projects. This helps us meet legal obligations, client requirements, and our own sustainability goals.

    We need to track and report our greenhouse gas (GHG) emissions accurately. This includes emissions from our vehicles, energy use, and any refrigerants we use. The SHEQ Department is responsible for calculating our carbon footprint and setting targets for reduction. Everyone has a role to play in identifying opportunities to save energy and reduce waste.

    By working together, we can minimize our environmental impact and contribute to a more sustainable future. If you have any questions or ideas, please reach out to the SHEQ Department.

    Key points

    • Our Carbon Management procedure (CP6: SHEQ 10.5) guides us in managing and reducing carbon emissions.
    • We must accurately track and report greenhouse gas (GHG) emissions from our operations.
    • The SHEQ Department calculates our carbon footprint and sets reduction targets.
    • Everyone plays a role in identifying opportunities to reduce energy consumption and waste.
    From the source document(1 clause)

    10.5Carbon ManagementEditedAdded

    10.5.1 Carbon management is addressed through the Company’s Carbon Management System, supporting procedures, and the Breheny Carbon Impact and Reduction Tool (BCIRT).

  11. 11Quality Management9 parts

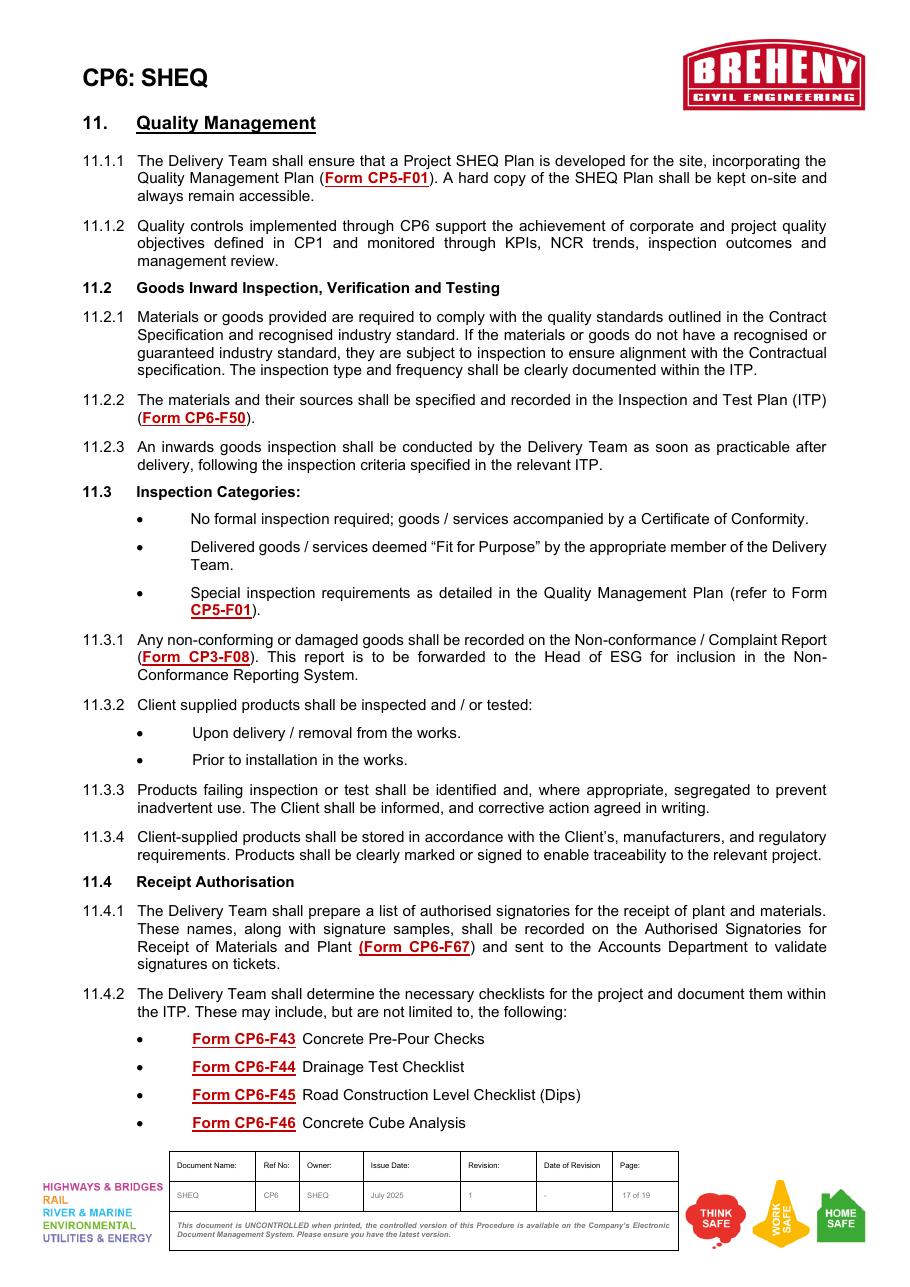

    11.1 Quality Management

    Every site must have a Project SHEQ Plan that includes the Quality Management Plan (Form ). A hard copy of the SHEQ Plan must be kept on site and accessible at all times.

    The quality controls in CP6: SHEQ  support the wider corporate and project quality objectives set out in CP1: IMSM. Performance is tracked through KPIs, Non-Conformance Report (NCR) trends, inspection outcomes and management review.

    Key points

    • A Project SHEQ Plan must be developed for every site and must incorporate the Quality Management Plan (Form ).
    • A hard copy of the SHEQ Plan must be kept on site and always accessible.
    • CP6: SHEQ  quality controls underpin the corporate and project quality objectives defined in CP1: IMSM.
    • Performance is monitored through KPIs, NCR trends, inspection outcomes and management review.
    From the source document(1 clause)

    11.1Quality ManagementEditedAdded

    11.1.1 The Delivery Team shall ensure that a Project SHEQ Plan is developed for the site, incorporating the Quality Management Plan (Form CP5-F01). A hard copy of the SHEQ Plan shall be kept on-site and always remain accessible. 11.1.2 Quality controls implemented through CP6 support the achievement of corporate and project quality objectives defined in CP1 and monitored through KPIs, NCR trends, inspection outcomes and management review.

    Documents you'll need

    11.2 Goods Inward Inspection, Verification and Testing

    Materials and goods supplied to site must comply with the quality standards in the Contract Specification and recognised industry standards. Where no recognised or guaranteed industry standard applies, the items must be inspected to confirm they align with the contract requirements. The type and frequency of inspection must be set out clearly in the Inspection and Test Plan (ITP).

    All materials and their sources must be specified and recorded in the ITP (Form ).

    The Delivery Team must carry out an inwards goods inspection as soon as practicable after delivery, following the inspection criteria in the relevant ITP.

    Key points

    • All materials must meet the Contract Specification and recognised industry standards.
    • If no recognised standard applies, the item must be inspected against the contract.
    • Inspection type and frequency must be documented in the ITP.
    • Materials and their sources must be recorded in the ITP (Form ).
    • The Delivery Team must inspect incoming goods as soon as practicable after delivery, using the criteria in the ITP.
    From the source document(1 clause)

    11.2Goods Inward Inspection, Verification and TestingEditedAdded

    11.2.1 Materials or goods provided are required to comply with the quality standards outlined in the Contract Specification and recognised industry standard. If the materials or goods do not have a recognised or guaranteed industry standard, they are subject to inspection to ensure alignment with the Contractual specification. The inspection type and frequency shall be clearly documented within the ITP.

    11.2.2 The materials and their sources shall be specified and recorded in the Inspection and Test Plan (ITP) (Form CP6-F50).

    11.2.3 An inwards goods inspection shall be conducted by the Delivery Team as soon as practicable after delivery, following the inspection criteria specified in the relevant ITP.

    Documents you'll need

    11.3 Inspection Categories

    There are three inspection categories for incoming goods and services:

    • No formal inspection required — where goods or services arrive with a Certificate of Conformity.
    • Fit for Purpose — where the appropriate member of the Delivery Team judges the goods or services fit for purpose.
    • Special inspection — where the Quality Management Plan (Form ) sets out specific inspection requirements.

    Any non-conforming or damaged goods must be recorded on the Non-conformance / Complaint Report (Form ) and forwarded to the Head of ESG for inclusion in the Non-Conformance Reporting System.

    Client-supplied products must be inspected and/or tested both on delivery (or removal from storage) and again before installation. Anything that fails inspection must be identified and, where appropriate, segregated to prevent accidental use; the Client must be informed and corrective action agreed in writing.

    Client-supplied products must be stored in line with the Client's, manufacturer's and regulatory requirements, and clearly marked or signed so they remain traceable to the project.

    Key points

    • Three inspection categories: Certificate of Conformity, Fit for Purpose, or Special inspection per QMP (Form ).
    • Non-conforming or damaged goods are logged on Form and sent to the Head of ESG.
    • Client-supplied products are inspected on delivery and again before installation.
    • Failed products must be identified and segregated; the Client must be informed and corrective action agreed in writing.
    • Client-supplied products must be stored to Client/manufacturer/regulatory requirements and clearly marked for traceability.
    From the source document(1 clause)

    11.3Inspection CategoriesEditedAdded

    11.3 Inspection Categories:

    No formal inspection required; goods / services accompanied by a Certificate of Conformity.

    Delivered goods / services deemed "Fit for Purpose" by the appropriate member of the Delivery Team.

    Special inspection requirements as detailed in the Quality Management Plan (refer to Form CP5-F01).

    11.3.1 Any non-conforming or damaged goods shall be recorded on the Non-conformance / Complaint Report (Form CP3-F01). This report is to be forwarded to the Head of ESG for inclusion in the Non-Conformance Reporting System.

    11.3.2 Client supplied products shall be inspected and / or tested:

    Upon delivery / removal from the works.

    Prior to installation in the works.

    11.3.3 Products failing inspection or test shall be identified and, where appropriate, segregated to prevent inadvertent use. The Client shall be informed, and corrective action agreed in writing.

    11.3.4 Client-supplied products shall be stored in accordance with the Client's, manufacturers, and regulatory requirements. Products shall be clearly marked or signed to enable traceability to the relevant project.

    Documents you'll need

    11.4 Receipt Authorisation

    The Delivery Team must prepare a list of people authorised to sign for plant and materials. Their names and signature samples are recorded on the Authorised Signatories for Receipt of Materials and Plant (Form ) and sent to the Accounts Department so signatures on delivery tickets can be validated.

    The Delivery Team must also decide which inspection checklists the project needs and document them in the ITP. These typically include:

    • Form — Concrete Pre-Pour Checks
    • Form — Drainage Test Checklist
    • Form — Road Construction Level Checklist (Dips)
    • Form — Concrete Cube Analysis
    • Form — Concrete Post-Pour Checks
    • Form — Concrete Record Sheet
    • Form — Drainage Track & Check Sheet

    Key points

    • Authorised signatories for receipt of plant and materials are recorded on Form .
    • Signature samples are sent to the Accounts Department to validate delivery tickets.
    • The Delivery Team selects the inspection checklists required for the project and lists them in the ITP.
    • Typical checklists: , , , , , and .
    From the source document(1 clause)

    11.4Receipt AuthorisationEditedAdded

    11.4.1 The Delivery Team shall prepare a list of authorised signatories for the receipt of plant and materials. These names, along with signature samples, shall be recorded on the Authorised Signatories for Receipt of Materials and Plant (Form CP6-F67) and sent to the Accounts Department to validate signatures on tickets.

    11.4.2 The Delivery Team shall determine the necessary checklists for the project and document them within the ITP. These may include, but are not limited to, the following:

    Form CP6-F43 Concrete Pre-Pour Checks

    Form CP6-F44 Drainage Test Checklist

    Form CP6-F45 Road Construction Level Checklist (Dips)

    Form CP6-F46 Concrete Cube Analysis

    Form CP6-F47 Concrete Post-Pour Checks

    Form CP6-F48 Concrete Record Sheet

    Form CP6-F49 Drainage Track & Check Sheet

    Documents you'll need

    11.5 Inspection and Test Plan (ITP)

    The Contracts Manager must make sure a suitable Inspection and Test Plan (Form ) is produced and put into use. The ITP sets the "standard" against which workmanship and materials are measured.

    At the Subcontract pre-let meeting, the Contracts Manager briefs Subcontractors on their obligations under the ITP. Where appropriate, the Subcontractor should produce their own project-specific ITP, which must be approved by the Contracts Manager and — where required — by the Client.

    The Delivery Team is responsible for implementing the ITP and making sure inspection records are completed throughout the project. They must also use reasonable endeavours to obtain signatures on inspection records from the Client, the Client's representative or the Adopting Authority, as set out in the ITP.

    The Delivery Team must maintain a Non-Conformance Register and make sure all NCRs are closed out.

    Key points

    • The Contracts Manager produces and implements the ITP (Form ).
    • Subcontractors are briefed on ITP obligations at the pre-let meeting and may produce their own project-specific ITP, subject to approval.
    • The Delivery Team implements the ITP and completes inspection records throughout the project.
    • Signatures from the Client / Client's representative / Adopting Authority must be obtained as set out in the ITP.
    • The Delivery Team maintains a Non-Conformance Register and closes out all NCRs.
    From the source document(1 clause)

    11.5Inspection and Test Plan (ITP)EditedAdded

    11.5.1 The Contracts Manager shall ensure that a suitable inspection and test plan (Form CP6-F50) is produced and implemented to establish the "standard" against which the quality of workmanship and materials are to be measured.

    11.5.2 At the Subcontract pre-let meeting the Contracts Manager shall advise the Subcontractors of their specific obligations under the ITP. Where appropriate, the Subcontractor should produce their own project-specific ITP, this should be approved by the Contracts Manager and where required, the Client.

    11.5.3 The Delivery Team shall be responsible for ensuring that the ITP is implemented and inspection records are completed throughout the duration of the project.

    11.5.4 The Delivery Team shall use reasonable endeavours to obtain signatures on inspection records from the Client / Client's representative / Adopting Authority as outlined in the ITP.

    11.5.5 The Delivery Team shall maintain a Non-Conformance Register and ensure NCRs are closed out.

    Documents you'll need

    11.6 Final Tests and Inspections

    The Delivery Team is responsible for making sure all final tests and inspections meet the contract requirements. If something fails, the Delivery Team must arrange remedial measures, re-testing and re-inspection until the works comply.

    Once all tests and inspections are successfully completed, the Delivery Team must issue the relevant test and inspection reports to the Client and/or their representative for acceptance, and make them available for inclusion in the H&S File.

    Key points

    • The Delivery Team must ensure all final tests and inspections meet the contract requirements.
    • If a test or inspection fails, remedial measures, re-testing and re-inspection are arranged until compliance is achieved.
    • Test and inspection reports are issued to the Client / Client's representative for acceptance.
    • Reports must be made available for inclusion in the H&S File.
    From the source document(1 clause)

    11.6Final Tests and InspectionsEditedAdded

    11.6.1 The Delivery Team shall be responsible for ensuring that all final tests and inspections meet the Contract requirements. In case of failure, the Delivery Team shall arrange remedial measures, re-testing, and re-inspection until compliance is achieved.

    11.6.2 Upon successful completion of all tests and inspections, the Delivery Team shall ensure that all relevant test and inspection reports are issued to the Client and/or their representative for acceptance and made available for inclusion in the H&S File.

    11.7 Test Equipment and Calibration

    The Delivery Team must make sure whoever is responsible for test equipment keeps all certificates and calibration records. Current calibration certificates must be available in the public area of the EDMS so other departments can access them — the Plant Department is responsible for keeping them up to date.

    Anyone in control of equipment with test certificates or calibration records must maintain a register showing the status of each item.

    All reference equipment used to calibrate the company's measuring and monitoring devices must be calibrated by an external agency or specialist accredited to National Traceable Standards (e.g. UKAS). Where calibrated equipment is hired in, the Purchase Order must specify that a current calibration certificate, traceable to national standards, is provided.

    The company's projects work to a general linear dimension tolerance of ±3 mm. That tolerance removes the need to calibrate tape measures and rules, provided damaged or suspect tapes and rules are immediately withdrawn, marked "NOT CALIBRATED – DO NOT USE" and replaced with items in good condition from an approved manufacturer.

    Equipment that fails calibration must be repaired or replaced, and repaired items must be re-calibrated before they go back into use.

    Key points

    • Calibration certificates are kept up to date by the Plant Department and made available in the public area of the EDMS.
    • Each person controlling test equipment maintains a register of items and calibration status.
    • Reference equipment must be calibrated by a UKAS (or equivalent) accredited body to national traceable standards.
    • Hired calibrated equipment must arrive with a current, nationally traceable calibration certificate (specified on the PO).
    • Tape measures and rules do not require calibration (±3 mm tolerance) but damaged items must be withdrawn and marked "NOT CALIBRATED – DO NOT USE".
    • Equipment that fails calibration is repaired or replaced; repaired items must be re-calibrated before reuse.
    From the source document(1 clause)

    11.7Test Equipment and CalibrationEditedAdded

    11.7.1 The Delivery Team shall ensure that the person responsible for test equipment maintains all associated certificates and calibration records. Current calibration certificates shall be made available in the public area of the EDMS for access by other departments. The Plant Department is responsible for ensuring these certificates remain up to date.

    11.7.2 Individuals controlling equipment with test certificates and calibration records shall maintain a register to monitor the status of each item.

    11.7.3 All reference items / equipment used to calibrate the company's measuring and monitoring devices shall be calibrated by an external agency or specialist accredited to National Traceable Standards (e.g. UKAS). 11.7.4 Where equipment or instruments requiring calibration procedures need to be hired, the Purchase Order to the supplier shall specify that a current calibration certificate, traceable to national standards, is provided. 11.7.5 The Company's projects have a general linear dimension tolerance limit of +/- 3mm. This tolerance eliminates the need to calibrate tape measures and rules, as long as damaged or suspect tapes and rules are immediately withdrawn, marked 'NOT CALIBRATED – DO NOT USE' and replaced with those in good condition from an approved manufacturer. 11.7.6 Equipment that fails calibration will be repaired or replaced, and items repaired will be re-calibrated before being issued for use.

    11.8 Performance Evaluation

    Quality performance after project completion — including defect trends, handover issues and lessons learned — is reviewed and recorded. This feeds continual improvement and future project planning, in line with the management review arrangements in CP3: Operational Control and CP2: Corporate Governance.

    For further detail, see CP2: Corporate Governance Management System Audits and CP2: Corporate Governance Management Review.

    Key points

    From the source document(1 clause)

    11.8Performance EvaluationEditedAdded

    11.8.1 Post-completion quality performance, including defect trends, handover issues and lessons learned, are reviewed and recorded to inform continual improvement and future project planning in accordance with CP3 and CP2 management review arrangements.

    11.8.2 See CP2 Management System Audits and CP2 Management Review

    11.9 Nonconformity and Corrective Action

    For the full process on dealing with non-conforming outcomes, refer to CP3: Operational Control Management of Non-Conforming Outcomes.

    All Non-Conformance Reports must be raised on Form and copies sent to SHEQadmin@breheny.co.uk.

    Key points

    • The full nonconformity and corrective-action process is set out in CP3: Operational Control Management of Non-Conforming Outcomes.
    • Non-Conformance Reports are raised on Form .
    • Copies of all NCRs must be sent to SHEQadmin@breheny.co.uk.
    From the source document(1 clause)

    11.9Nonconformity and Corrective ActionEditedAdded

    11.9.1 See CP3 Management of non-conforming outcomes. Copies of NCRs (CP3-F01) raised are to be sent to SHEQadmin@breheny.co.uk.

    Documents you'll need

Tables & figures

All tables, charts and diagrams extracted from the source PDF.
